Effort Allocation uses our “WBS planner” feature leveraging the new xl360 Canvas platform.

  • Effort Allocation displays the resources and effort assigned to the WBS tasks, allowing to visualise and maintain the information in different time units such as day, week, month, or year.
    This view also provides the following capabilities:
  • Assign new team members to tasks.
  • Maintain the project structure adding new tasks, subtasks.

Configuration

The Enhanced “Effort Allocation” will be activated automatically when “WBS Planner (Preview)” feature is activated. The enhanced experience will allow users to maintain Tasks, Team members and Effort assignments directly from the same “Effort allocation” screen.

Go to Settings > General > Parameters > Projects360 > Enable WBS Planner
Go to Settings > General > Parameters > Projects360 > Enable Effort Allocation

Details of the fields required for Enhanced Effort Allocation functionality are as follows:

Fields Description
Enable WBS Planner Set as “Yes” to activate the new projects360 “WBS Planner” spreadsheet within the Project form.
Enable Effort Assignment Set as “Yes” to activate the new projects360 “Effort Assignment” spreadsheet within the Project form.
Enable Effort Allocation Set as “Yes” to activate the projects360 “Effort Allocation” spreadsheet within the Project form.

Enhanced Effort Allocation

The Effort Allocation Spreadsheet has basic fields like start and end dates for each task, which match the ones in the WBS. It also lets you choose how often you want to track time (daily, weekly, etc.). Based on this choice and the costs for each person working on the tasks, it estimates how much everything will cost. Users can then compare this estimate to the actual costs by turning on the “Show Actuals” feature.
To better understand, let’s take a closer look at these fields.

Fields Description
Start Date When you set a start date for a task in the WBS, it automatically shows up on the Effort Allocation spreadsheet. If you change the start date later, the Effort Allocation automatically updates to reflect the new dates.
End Date The end date for each task in the WBS automatically sets the end date for that task in the Effort Allocation spreadsheet. You can change the end date in the spreadsheet, and this will directly affect how much time each person is assigned to the task.
Time Scale The “Time Scale” lets users see different views of project data like effort, cost, fees, and actuals for people working on tasks. It shows this information based on what time frame they’re interested in, like daily, weekly, monthly, or yearly. Remember, this view depends on the start and end dates entered in the Effort Allocation spreadsheet, so changing those dates will update the information you see.
Show Cost/Fee “Show Cost/Fee” makes it easy to see estimated costs and fees for each task.
  • For each person working on a task (Roles/Resources) users will see their estimated cost and fees.
  • Helps to analyse cost and fees are based on the work planned in the WBS.
  • Helps to analyse cost and fees changes after you adjust the amount of work people do in the Effort Allocation spreadsheet.
Show Actuals “Show Actuals” gives you a clear view of :
  • Time resources/roles have actually spent on tasks(Actual Effort).
  • Time resources/roles are left to finish tasks(Remaining Effort).
  • Time resources/roles were originally expected to spend(EAC Effort).
Note – Changes to hours for individual roles in the WBS automatically update the Effort Allocation spreadsheet. However, changing efforts directly in the Effort Allocation spreadsheet won’t update the WBS until you click “Publish.” So remember, updates flow one way automatically, but the other way needs a final confirmation.
This means you can budget and estimate how much resources each task needs, all within the Effort Allocation spreadsheet and reflected in the WBS whenever you save your changes.

To understand how effort allocation, cost, and fees for Roles/Resources working on tasks can be affected, let’s look at a few scenario.

Scenario 1: When Time Scale is set as “Week” and Show Cost/Fee is set as “No” and Show Actuals is also set as “No”.
Users can see this information for the whole project (header level) and for each person working on it (individual level). Since it is set to weekly, it shows hours worked week by week. This report updates automatically if you change the time frame to daily, monthly, or yearly. Let’s take a closer look at each field.

Fields Description
Name The “Name” column shows both the project name and any tasks inside that project. This information is shown for both the main project and all its subtasks.
Assigned to The “Assigned to” field shows who’s working on each task, including their names and assigned roles. This helps users easily see everyone involvement in each task. If users are not sure whom to assign to a task, a generic resource will be automatically assigned and shown in the “Assigned to” field. Right-clicking “Assigned to” allows for efficient resource allocation. You can assign existing Bookable resource or create new generic resources, facilitating resource booking.
  • Assign an existing team member : This replaces the generic placeholder with their name and role, reflecting their availability in booking and scheduling.
  • Add a new team member : This creates a new person with a specific role, making them available for scheduling and costing.
Start When creating a project, the start date is automatically set to the earliest start date of all its subtasks. You can still see the start date of each individual task. You can even change them one by one, and these changes will update in the WBS once you save them.
Finish When creating a project, the finish date is automatically set to the latest date of all its subtasks. You can still see the finish date for each individual task. You can even change them one by one, and these changes will update in the WBS once you save them.
Duration Task duration shows how many workdays it takes in total, from start to finish. But it only counts actual workdays for tasks where someone is assigned.
Out of Range The “Out of Range” field shows the total efforts of resources that do not fall between the start date and end date of the task.
Effort When tasks are automatically created from the WBS, their effort levels generates from the WBS itself. You can’t directly change these values in the Effort Allocation spreadsheet. However, you can adjust the effort for each resource by choosing a specific timeframe (daily, weekly, etc.). These adjustments will increase or decrease the overall effort and update both the resource level and task level in the Effort Allocation spreadsheet and WBS once you publish the changes.
Updated Effort When you first assign resources to tasks from the WBS, the “Effort” and “Updated Effort” fields show the same amount of time. But the “Effort Allocation” tool lets you adjust the time each resource spends on a task (increase or decrease it). These changes automatically update the “Updated Effort” field for both the resource and the overall task.

When you open the Effort Allocation spreadsheet, you can choose how you want to see time, like by day, week, or year. This lets you see the Resource allocation and assignment details for that specific timeframe.

  • When you choose “Day” for the time scale, you will see all the dates from the start date at the top to the end date at the bottom in the Effort Allocation spreadsheet. But remember, it only shows effort for workdays. For non-working days, you won’t see any data.

  • When you choose “Weekly” in the Time scale, you’ll see the weekly schedule based on the spreadsheet’s start and end dates. The total effort for each week is shown at the resource level, task level, and summed up for the entire project. You can only adjust the effort at the resource level, and these changes will update both the “Effort” and “Updated Effort” fields for both resources and tasks.

  • When you choose “Monthly” as the time scale, the system shows the month for each task’s start and end date. It then groups effort by month for resources, tasks, and the whole project. You can only adjust effort for resources, and those changes affect both the original “Effort” and the updated “Updated Effort” fields at both the resource and task levels.

  • When you choose “Yearly” as the time scale, you’ll see which year each task start and end date falls in. This way, you can easily see the total effort for each year, both for individual resources and tasks, as well as the overall project total. You can only adjust the effort for individual resources within this view, and the changes will affect both the “Effort” and “Updated Effort” fields for both the resource and the task.

Scenario 2: When Time Scale is set as “Month” and Show Cost/Fee is set as “Yes” and Show Actuals is set as “No”.

If you turn on “Show Cost/Fee” in the Effort Allocation spreadsheet, you’ll see all the information from before (like in Scenario 1) plus some new fields. These new ones track both cost and fees, like “Effort Cost” and “Updated Effort Cost”. Let’s dive into one of these new fields:

Fields Description
Effort Cost “Effort Cost” shows how much it costs to have each person work on a task. The total cost adds up for each task and is shown at the top. It’s calculated by formula Effort Cost : Effort(Hours) * Cost price of Role/Resource. We set these rates in the “Cost Price” list under Project Parameter settings.
Effort Fee The Effort Fee indicates the total fee assigned to a role or resource, calculated based on effort and hourly rate.. The total fee for each task is shown at the top. Here is how it works:
  • Effort Fee : Effort (hours) * Resource Hourly Rate
  • Effort: The total time each resource spends on a task.
  • Resource Hourly Rate: The sales price per hour for each role or resource can be set within the sales price list that is attached to the contract for the specific project.
Updated Cost The “Updated Effort Cost” shows how much it costs to have people working on each task. This cost is calculated by formula Updated Cost : Updated Effort * Cost Price of the Resource/Role. You can change the Updated Effort for each person to adjust the overall cost. All these costs are added up and shown at the top of each task.
Delta Effort Cost The Delta Effort Cost refers to the difference in cost that occurs when there are changes or adjustments in the allocated effort for a particular task or project. This cost is calculated using the formula Delta Effort Cost = Updated Cost – Effort Cost. Whenever the Delta Effort Cost is negative, it is highlighted in red for that particular task.
Updated Fee The “Updated Effort Fee” displays the fees for each assigned role or resource on a task, based on their updated effort. Updated Fee : Resource’s updated effort (how much time they spend on the task) * hourly rate (set in the sales price list). It also gets added up for all resources working on the same task, giving you a total “Updated Effort Fee” for the whole task.
Note – Once you make changes in the “Effort Allocation” spreadsheet and publish it, the number of hours each person spends on a task (Efforts) will eventually match the updated hours. This means the cost and fee for each person’s effort will also be updated. Basically, everything gets recalculated in the WBS to reflect the new effort levels, including hours, sales, and costs for each resource assigned to tasks.

Scenario 3 : When Time Scale is set as “Yearly” and Show Cost/Fee is set as “Yes” and Show Actuals is set as “Yes”.
Turning on “Show Actuals” in the Effort Allocation spreadsheet shows even more information! You’ll see everything from Scenario 1 and 2, plus additional fields like :

Fields Description
Actual Effort The “Actual Effort” field shows the total time people actually spent on each task. This gets added up to show the total project time at the top of the spreadsheet. Once Actual efforts are updated, it can’t be edited again.
Remaining Effort The “Remaining Effort” shows how much work is left on each task. It’s calculated by adding up the estimated time for all assigned resources and displaying it both at the individual task level and as a combined total for the entire project at the top of the spreadsheet. The “Remaining Effort From” filter plays a crucial role in determining the remaining effort of a task. It calculates the effort needed from the specified “Remaining Effort From” date to the task’s end date, considering the effort required within this date range.
EAC Effort “EAC Effort” in project management refers to the Estimate at Completion (EAC) of effort required to complete a project. It is calculated using the formula EAC Effort = Actual Effort + Remaining Effort.
EAC vs Planned It is the total planned value for the project, determined at the beginning of the project and based on the project work. It is calculated using the formula: EAC vs Planned : Effort – EAC Effort.
Actual Cost The “Actual Cost” field shows the total cost spent on a project task for all Bookable/Generic Resources assigned to it. This cost is calculated by adding up the costs of all resources/roles who worked on that specific task. It is recorded at the project task header level, providing a consolidated view.
Remaining Cost The “Remaining Cost” field shows the estimated amount spend by Bookable/Generic Resources for a project task. This cost is calculated by formula Remaining Cost = Remaining effort on the task * Combined cost of all Bookable and Generic Resources assigned to it. It considers the timeframe from “Remaining effort from” to the task “Finish date”.
EAC Cost The “EAC Cost” (Estimate at Completion Cost) refers to the projected total cost of a task or project at completion. This cost is calculated by formula EAC Cost = Actual Cost + Remaining Cost.
EAC Cost vs Planned The “EAC Cost” (Estimate at Completion Cost) refers to the projected total cost of a task or project at completion. This cost is calculated by formula EAC Cost vs Planned = Effort Cost – EAC Cost.
Actual fee The “Actual fee” field shows the total fee spent on a project task for all Bookable/Generic Resources assigned to it. This fee is calculated by adding up the “Unbilled Sales” amount of all resources/roles who worked on that specific task. It is recorded at the project task header level, providing a consolidated view .
Remaining fee The “Remaining fee” field shows the estimated sales amount spend by Bookable/Generic Resources for a project task. This fee is calculated by formula Remaining fee = Remaining effort on the task * Combined sales amount of all Bookable and Generic Resources assigned to it. It considers the timeframe from “Remaining effort from” to the task “Finish date”.

Configurable Weekly Period on Effort Allocation

The Configurable Weekly Period feature allows users to configure the first day of the week instead of defaulting to Sunday when the Time scale is set to ‘Week’, providing flexibility for companies operating in different countries with varying calendar standards.

Configuration

The highlighted section below shows the essential setups that System Administrator must configure to inherit the ‘Week Start Day’ on the Effort Allocation.

  • The parameter ‘Week Start Day’ allows to inherit the specified day of a week as a start day of the week on the Effort allocation of a project.

Go to Settings > General > Company Parameters -> General -> Effort allocation parameters -> Week Start Day

  • The efforts assigned to resources and their corresponding dates are automatically recalculated according to the Week Start Day when modified in Effort Allocation.
  • This ensures that all effort distributions align consistently with the company’s chosen weekly structure, whether the week begins on Sunday, Monday, or another designated day.
  • By applying this parameter, the system adjusts both the scheduling of assignments and the effort breakdowns, providing accurate alignment with organizational standards and regional practices.
Note – When the Week Start Day parameter is left blank or set to null, the system automatically defaults to Sunday as the start of the week in Effort Allocation. This default also applies to all the existing projects. This feature is also available for Microsoft Planner projects.

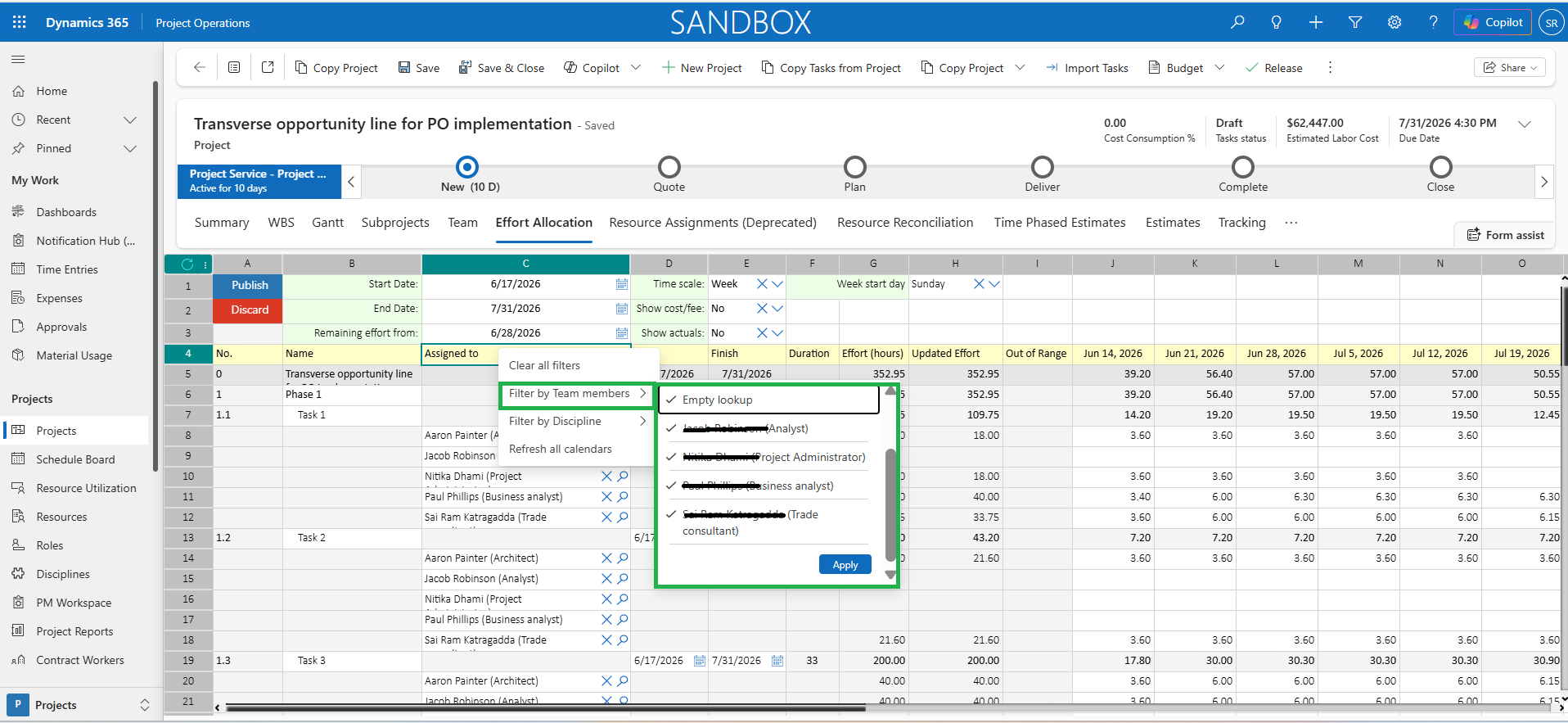

Ability of filtering by the “Assigned To” column in the “Effort Allocation” spreadsheet

We have the possibility of filtering by “Assigned to” column in the “Effort Allocation” spreadsheet. This filter allows users to sort Bookable and Generic Resources easily. It helps them focus specifically on their activities such as tasks and allocated efforts.

  • To apply a filter, simply right-click on the “Assigned to” column. From there, you can choose “Filter team members” and then select or unselect the resources you want to view.
  • The entire project structure will remain visible, but only rows with assigned resources will be filtered accordingly.

Refresh Calendars contextual menu option in Effort Allocation

This contextual menu option will allow users to refresh the calendar information based on configuration updating the period cells for each ‘Bookable Resources’ in the ‘Effort Allocation’ spreadsheet.

  • The period cells to enter specific effort will be dynamically updated as editable or non-editable based on the latest configuration set in the Bookable Resource Work Hour Calendar.
  • By right-clicking on the ‘Assigned To’ field and selecting ‘Refresh All Calendars’, the spreadsheet cells will be updated for all bookable resources.
  • By right-clicking on a specific bookable resource and selecting ‘Refresh Calendar’, the cells for that resource will be updated to reflect the latest calendar configuration.

Cell locking for out of range and non-working periods in Effort Allocation

Effort cells are locked to prevent updating values for time periods out of the Start and End Date range. This precautionary measure aims to minimize human errors.

  • This validation ensures the bookable resources are properly updated within the designated task period.
  • In addition, non-working periods will be non-editable as well, ensuring data accuracy.

Default Time Scale for Effort Allocation

This enhancement introduces a new capability that allows users to set a default time scale for the Effort Allocation tab to display the efforts, directly from the Project Parameters.

  • A new dropdown parameter, Effort Allocation Time Scale, is added to the Project Parameters form. It offers the same time unit options—Day, Week, Month, and Year—as the Effort Allocation time scale selector.

  • When a user selects a default time scale in the Project Parameters, the Effort Allocation tab will automatically apply and display efforts according to that chosen time scale.

Note – Subsequent refreshes retain the most recently used time scale by the user, overriding the default time scale until the project is reopened or time scale is manually changed again.

Alphabetical Display of Resources and Roles in ‘Assigned To’ column of Effort Allocation

. This enhancement improves how Resources and Roles appear in the Effort Allocation spreadsheet—especially in the “Assigned To” column—after syncing from the WBS. Displaying entries in a consistent order improves readability and usability.

  • Resources and Roles are now sorted alphabetically in the “Assigned To” column, using the full Resource/Role combination as the sort key.
    • Example:
      • Barrack (Business Analyst)
      • Generic Resource (Business Analyst)
      • Generic Resource (Developer)
      • Generic Resource (Lead Consultant)
      • Hector (Developer)
  • When one resource has multiple roles, they are listed alphabetically by role.
    • Example: Andrew (Administrator) appears before Andrew (Project Consultant)
  • The updated logic also handles multiple labor items with the same role (and no associated bookable resources). The display now respects defined positions or priorities, ensuring, for instance, that “Finance Consultant  2” appears after “Finance Consultant” in the intended order under “Assigned To” column.

Note – Newly created assignments may not appear in order immediately—but a simple spreadsheet refresh will apply the correct alphabetical sort.

Move all assignments:
In Effort Allocation spreadsheet, all assignments from a selected resource across every task in the project can be moved to another resource in one simple action. This saves time and eliminates the need for manual updates. After the transfer, assignments are automatically published, so changes are visible right away in the project.

Fields Description
Team member The “Team member” field displays the current assignment selected on the task by default whose assignments to be moved to other team members.
Resource to The “Resource to” field allows the users to select the resource to whom the assignments should be moved.
  • If the ‘Resource to’ selected does not exist as a team member in the project, a new team member will be created using the current role from the ‘Team member’ selected and assignments are moved to the new team member.
  • If the ‘Resource to’ selected exists as a team member in the project and has the same role but no assignments, then the assignments of the ‘Team member’ selected will be moved to the ‘Resource to’ selected.
  • If the ‘Resource to’ selected exists as a team member in the project and has the same role with some assignments already associated, the system will not allow to proceed and will display an error message.
  • If the ‘Resource to’ selected exists as a team member in the project but has a different role, then a new team member will be created and assignments are moved to the new team member.

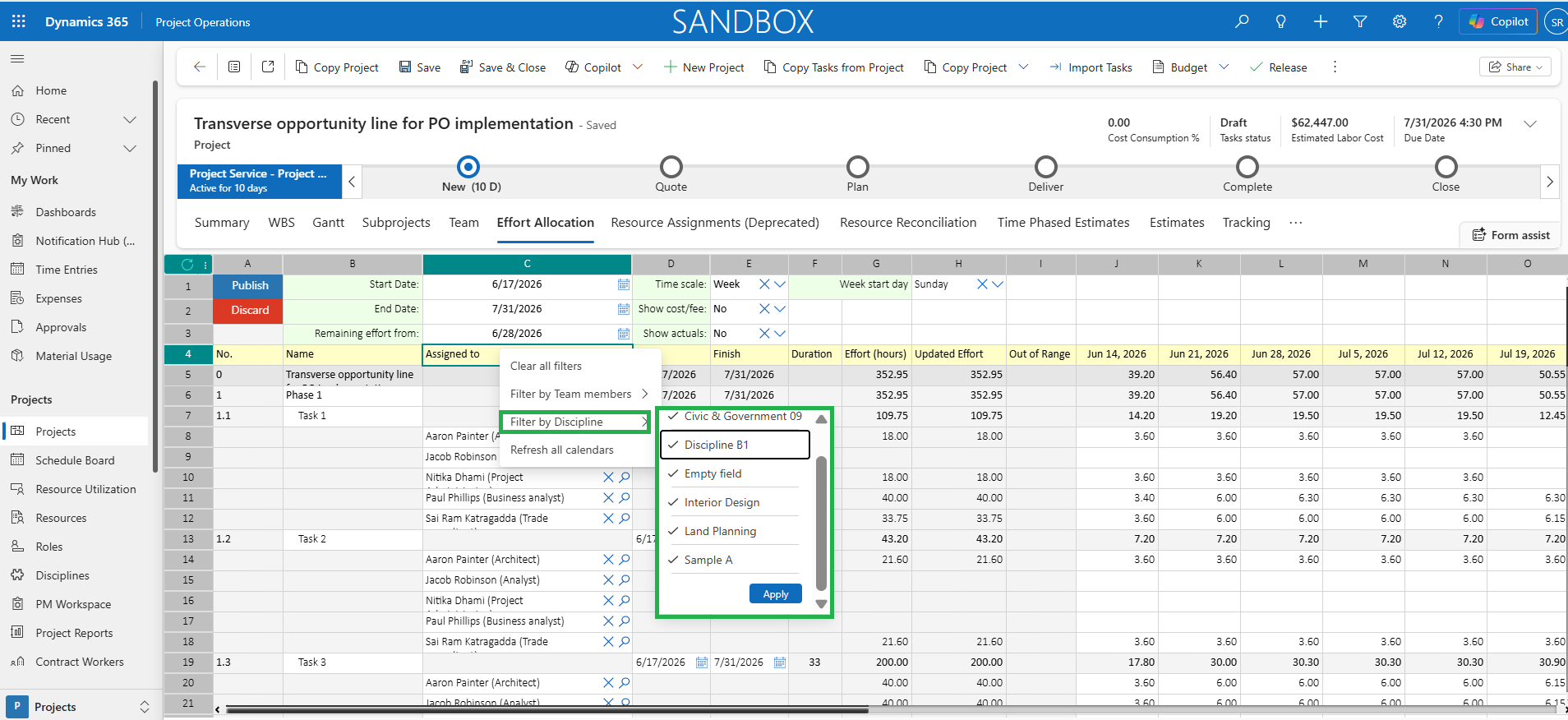

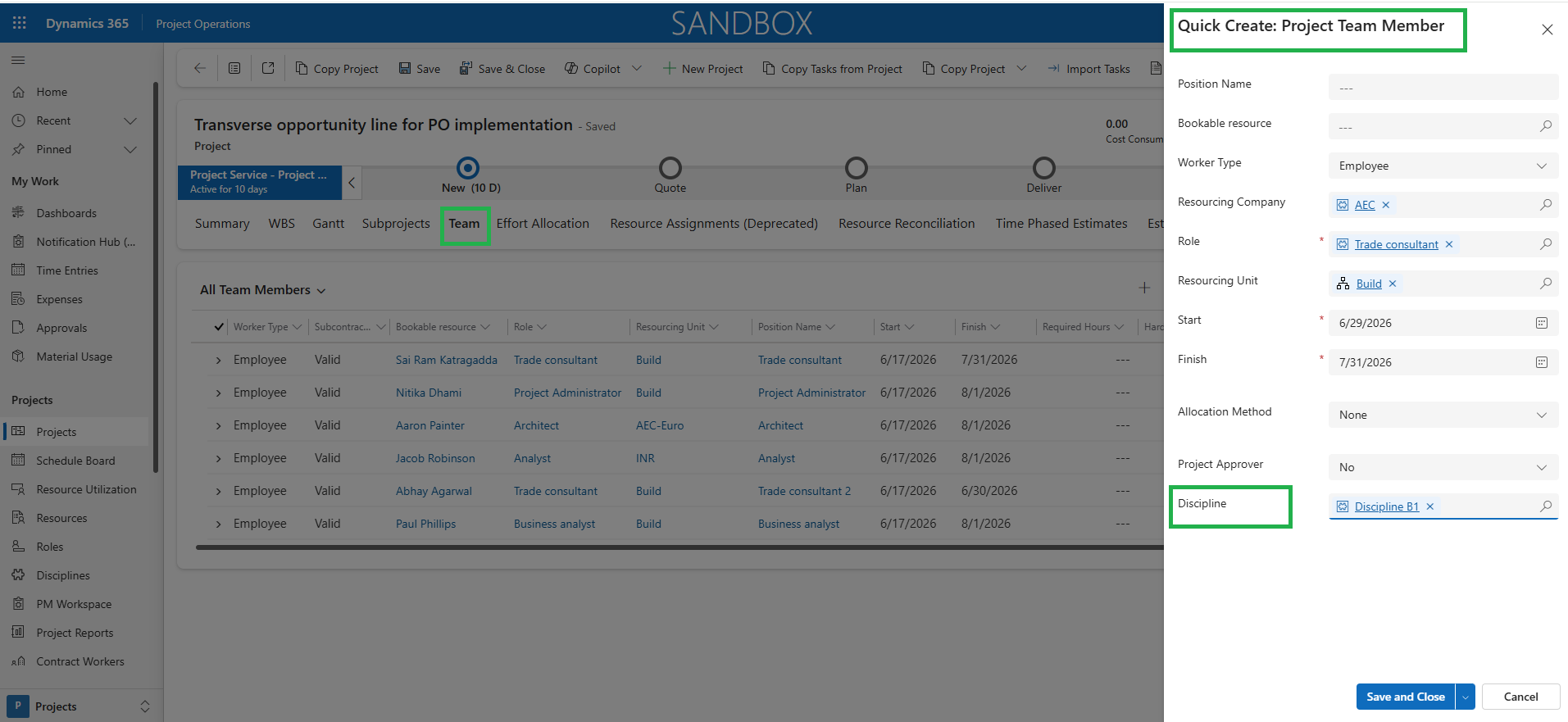

Filter assignments by Discipline and Team members
The Effort Allocation Spreadsheet helps users to filter assignments by team member and discipline, making it easier to view workload and resource allocation. The option is available by simply right clicking on the ‘Assigned to’ field.

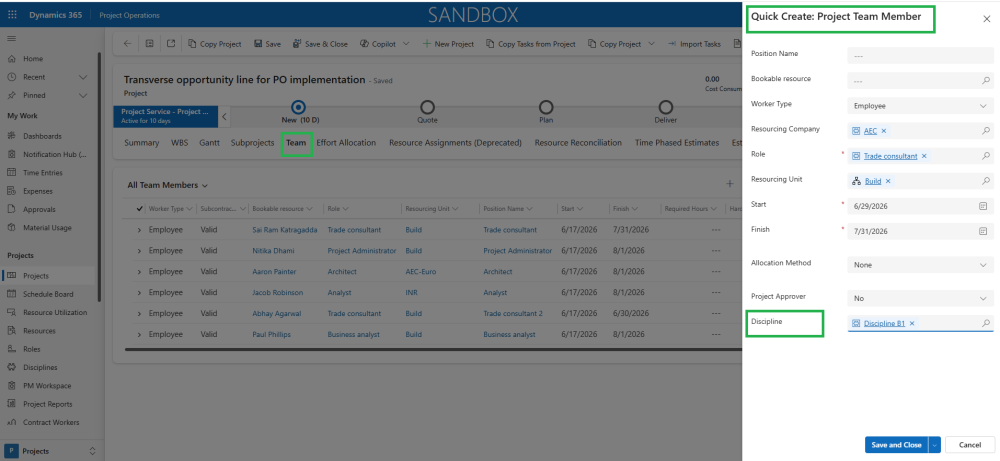

  • This enhancement is made possible by allowing users to associate a Discipline with both team members and tasks.
    • A Discipline can be associated with a team member when creating or editing a team member. Also, the discipline set on the bookable resource will be defaulted while creating the team member.

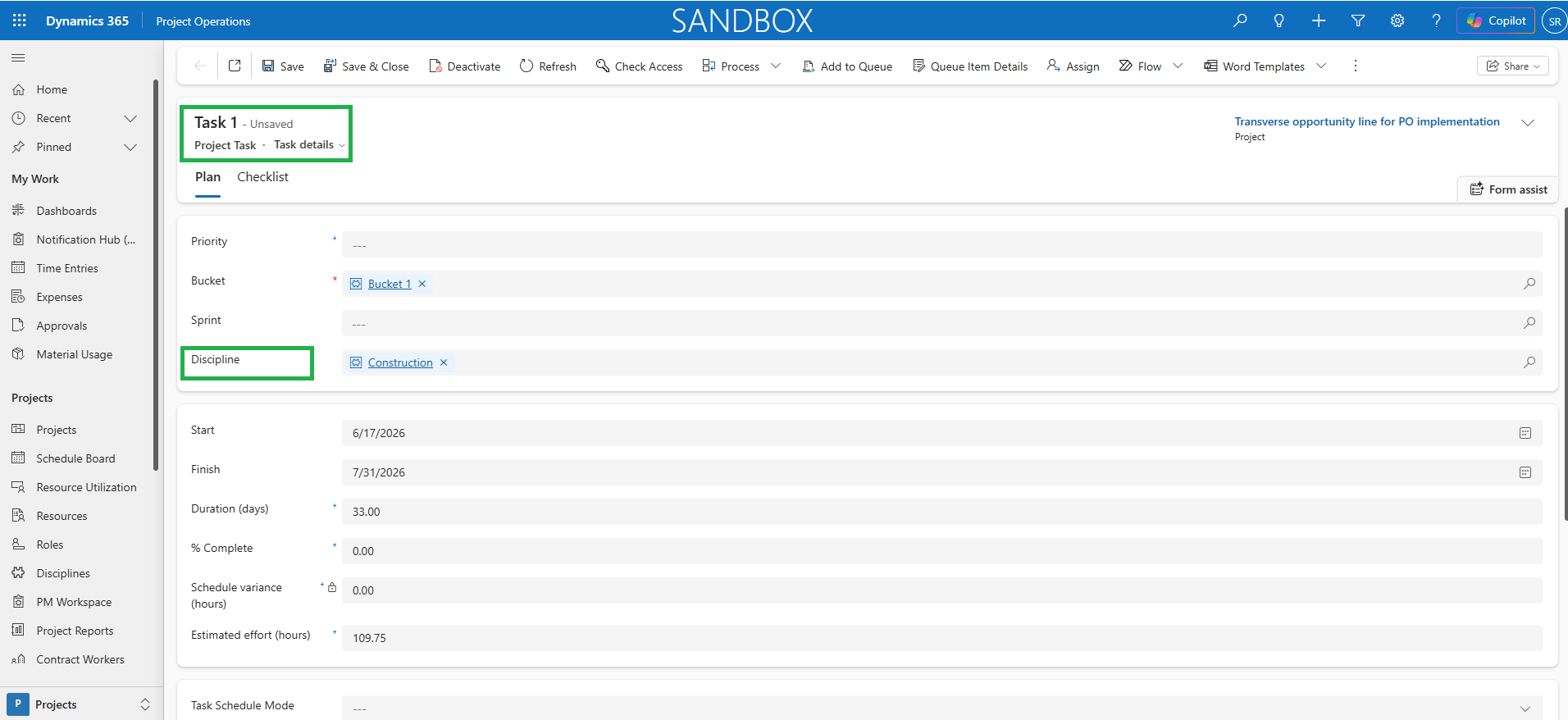

  • A Discipline can be associated with a task when creating or editing a task.

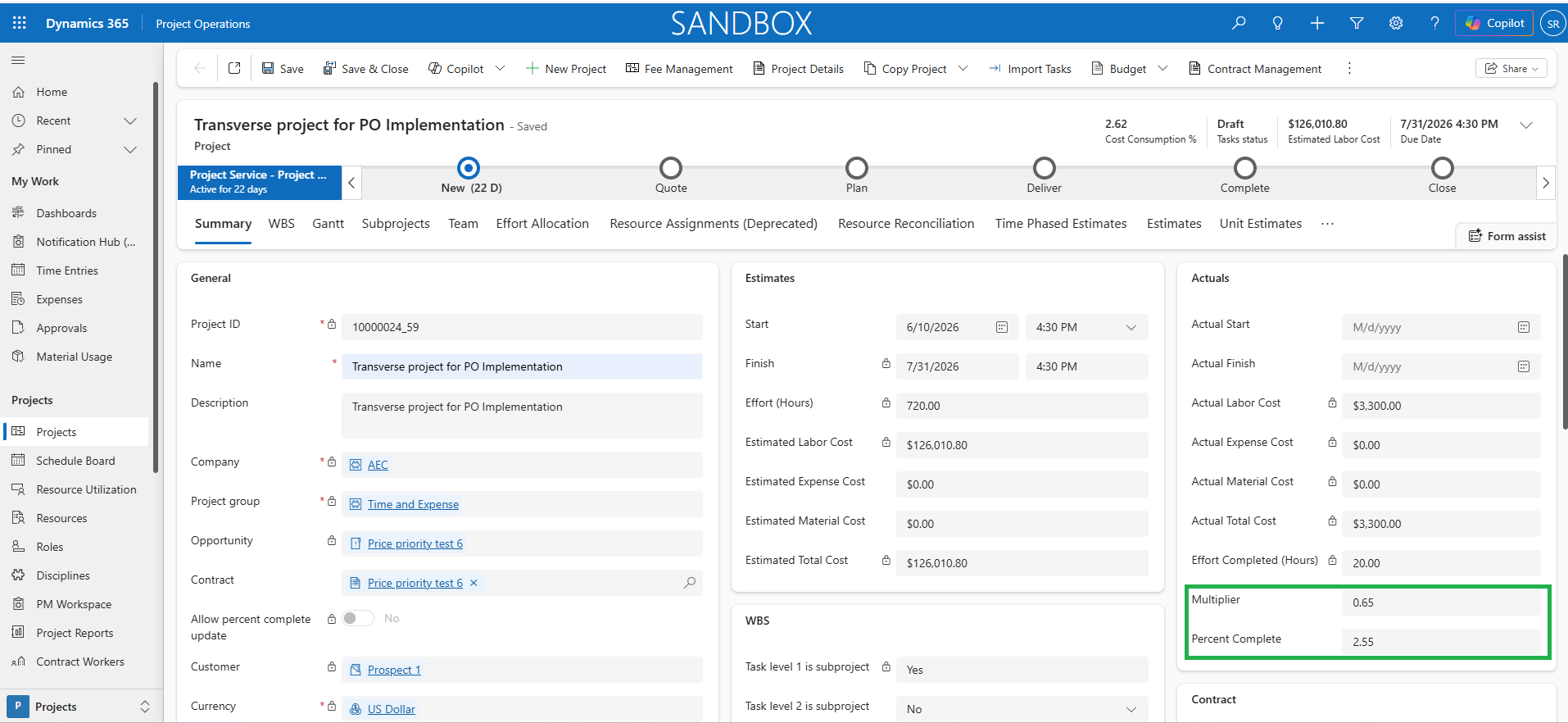

Multiplier and Percentage Complete Calculations

Multiplier and % Complete metrics provide additional visibility into project performance and progress. These values are calculated during the Effort Allocation publish process based on configured calculation logic and are made available for project tracking, reporting, and analysis.

Multiplier
The multiplier is calculated as updated (EAC cost / Total labor contract value) × 100.

Percentage Complete

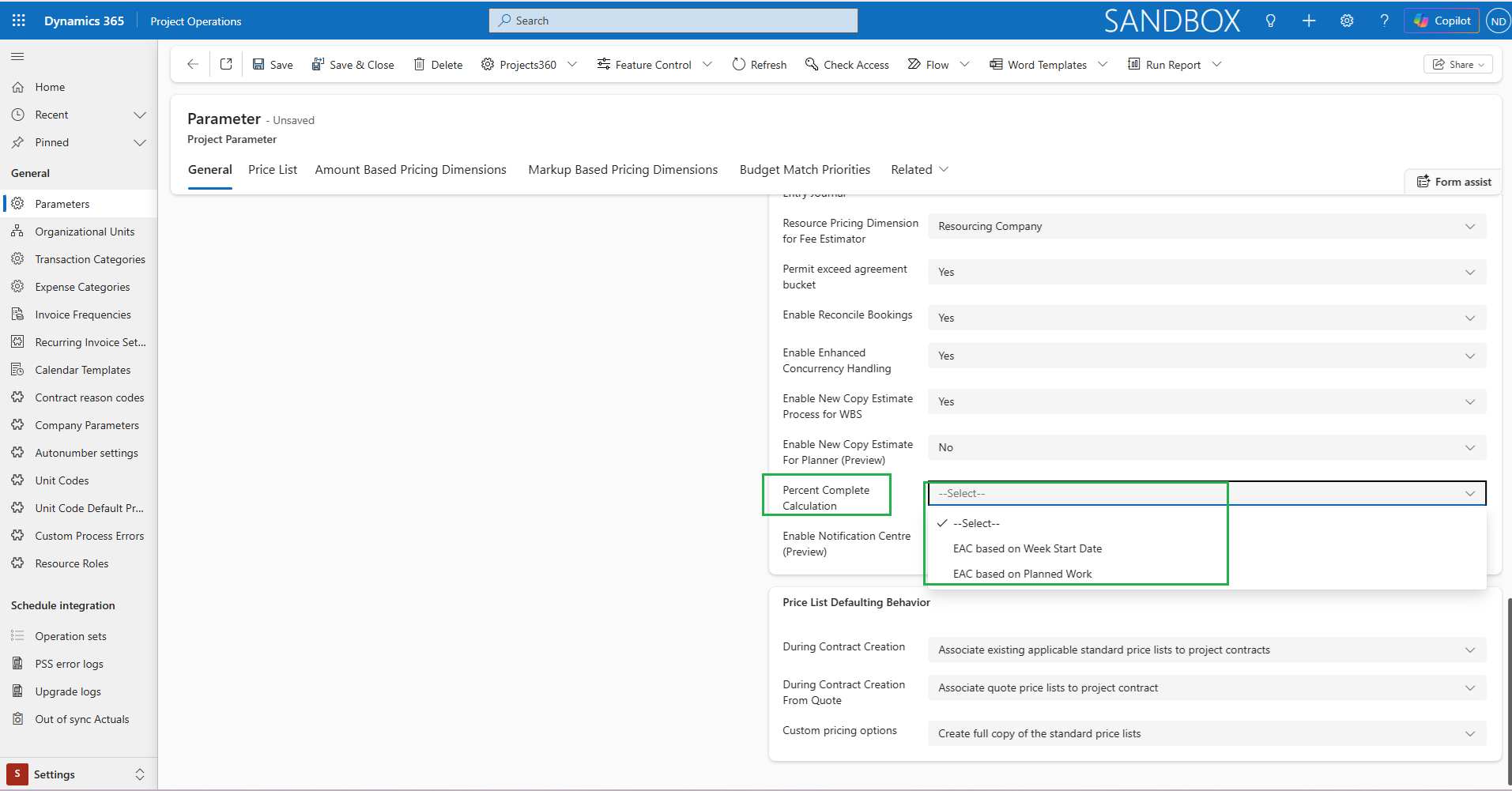

The Percentage Complete Calculation parameter determines the formula used to calculate the Percentage Complete value during the Effort Allocation publish process.

  • When the parameter is set to EAC based on planned work, the system calculates Percentage Complete using.
    • (Actual Cost / Updated Cost) × 100.
  • When the parameter is set to EAC based on week start date, the system calculates % Complete using.
    • (Actual Cost / EAC Cost) × 100.
