The Work Breakdown Structure helps users break down a project into smaller tasks and assign people or teams to do them. Users can easily estimate both labor and expense costs for their projects. The WBS helps by providing details about the roles involved and expenses incurred for each defined task. This makes it easier to track everything in a clear and organized way. The WBS is a helpful tool because everyone on the team can break down tasks, add smaller subtasks, and assign resources and expenses.
The WBS is a complete tool for users because it lets them track project estimates from different versions of a proposal. You can easily copy budgets and forecasts from the Fee Estimator to the WBS. Then, you can adjust things as needed by adding roles, expenses, or even new tasks. This automatically updates the overall estimates for labor, expense cost, effort allocation, and individual task expenses.
We decided to create the Work Breakdown Structure (WBS) feature because we noticed some things:
- Using tasks in Project Operations normally needs extra licensing with Microsoft Project Online. But the good news is, the Work Breakdown Structure (WBS) planner comes built-in! This means anyone on your project team can add tasks and estimate expenses and resources, as long as they have the right permissions.
- The WBS helps break down projects into smaller tasks, showing both the expected cost and sales price for each. It also calculates the profit and profit margin, making it easy for everyone to understand the financial picture of the project.
- This feature leverages the new xl360 platform built as canvas application.
- Disconnected from MS P4W, it will allow us to use almost unlimited level of tasks and resource assignments
- Tasks, Team members, Expenses and Effort assignments can be maintained on real time from a single screen directly in the Project form.
Configuration
The section highlighted below are the mandatory setups that needs to be configured by System Admin to use the WBS Planner.This feature can be enabled from the Parameters.
“WBS Planner (Preview)” is a key new feature that will replace MS Projects for the Web when activated. This feature will allow users to maintain the project structure, fee and expense estimates as well as resource assignment from just one view.
Go to Settings > General > Parameters -> Project360 -> Enable WBS Planner
Details of the fields required for WBS Planner Functionality are as follows:
| Fields | Description |
| Enable WBS Planner | Set as “Yes” to activate the new projects360 “WBS Planner” spreadsheet within the Project form. |
| Enable Effort Assignment | Set as “Yes” to activate the new projects360 “Effort Assignment” spreadsheet within the Project form. |
| Note – This is a “Preview” feature, and it can be activated and deactivated by configuration. Implementations using MS P4W can continue using it. |
Work Breakdown Structure

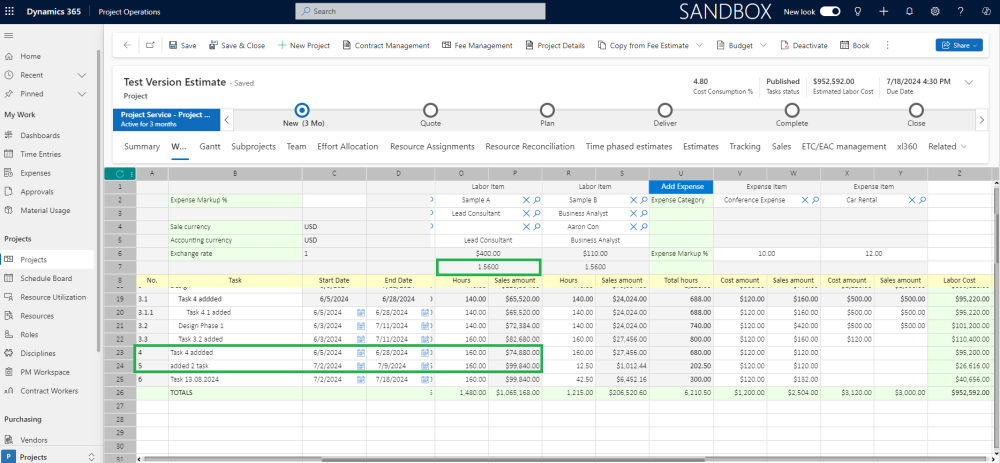

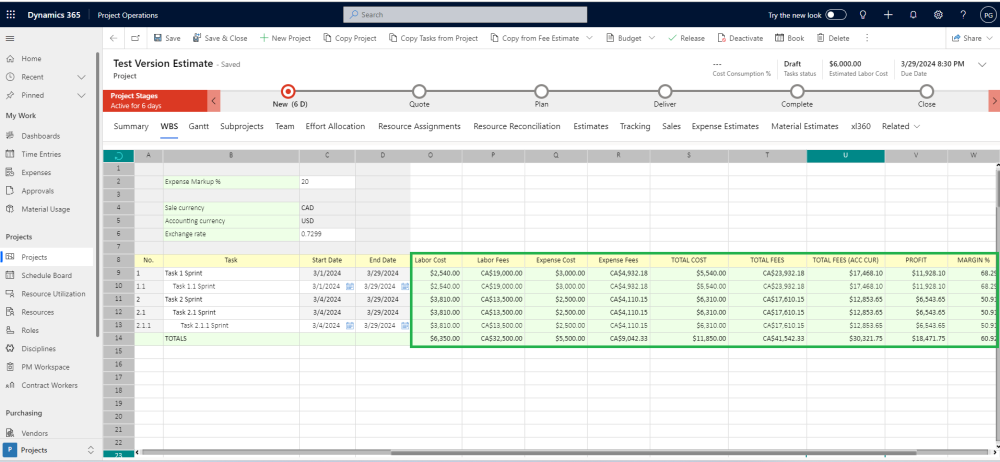

If you click on the WBS tab and copy Estimates using the “Copy from Fee Estimates Button”, all the Tasks, Roles, Expenses, Total Cost, Sales, Margin, Profit%, etc., will be transferred from the selected version. If no Estimates need to be copied, the WBS will have a Standard spreadsheet with various buttons like “Add Labour” and “Add Expense Button”, and multiple fields such as Expense Markup%, Sales Currency, etc.
The fields on the top left of WBS in the WBS planner spreadsheet are as follows:
| Fields | Description |
| Expense Markup Percentage |
|
| Sales Currency | Sales Currency shows the currency of Contract related to the Project. |

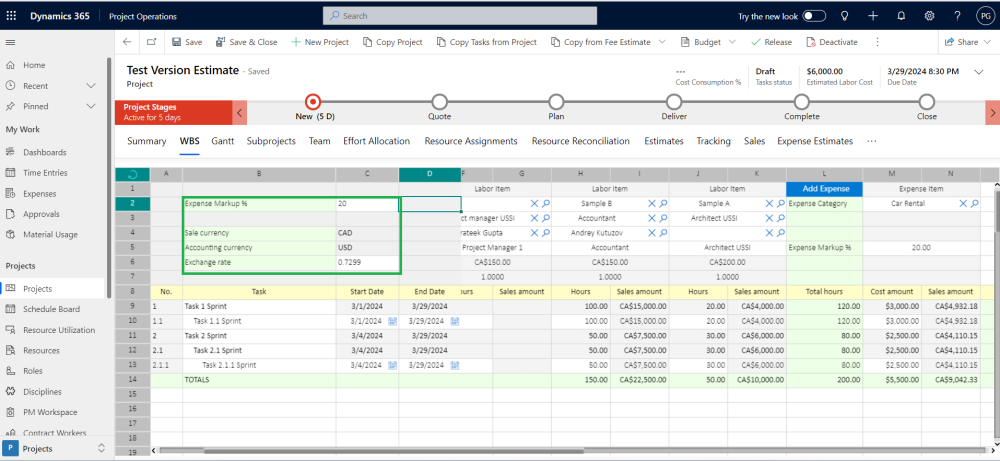

| Accounting Currency | Accounting Currency shows the currency of the “Contracting unit Company” to which the Project belongs. This means that WBS will use the same currency as the Project itself. |

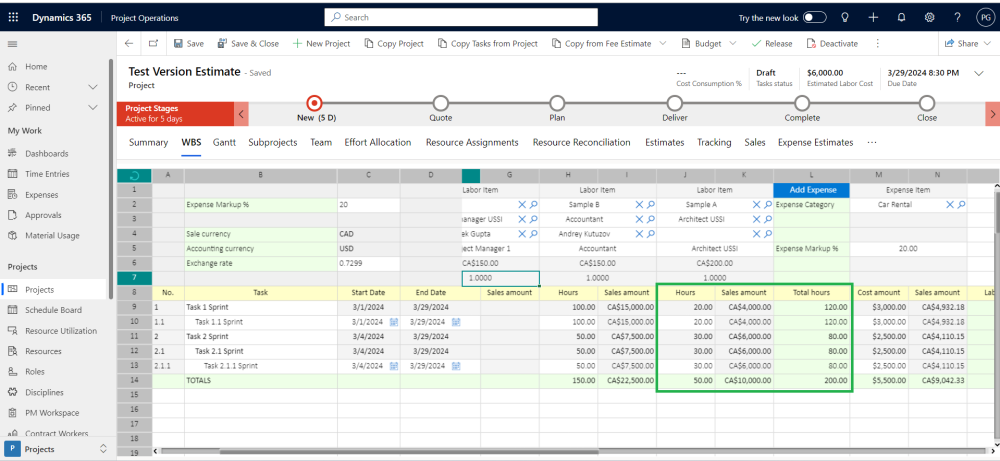

The fields highlighted in yellow contain the list of Tasks to be defined in the WBS. These tasks can be added manually or copied from Fee Estimates.
| Fields | Description |
| Task |
|

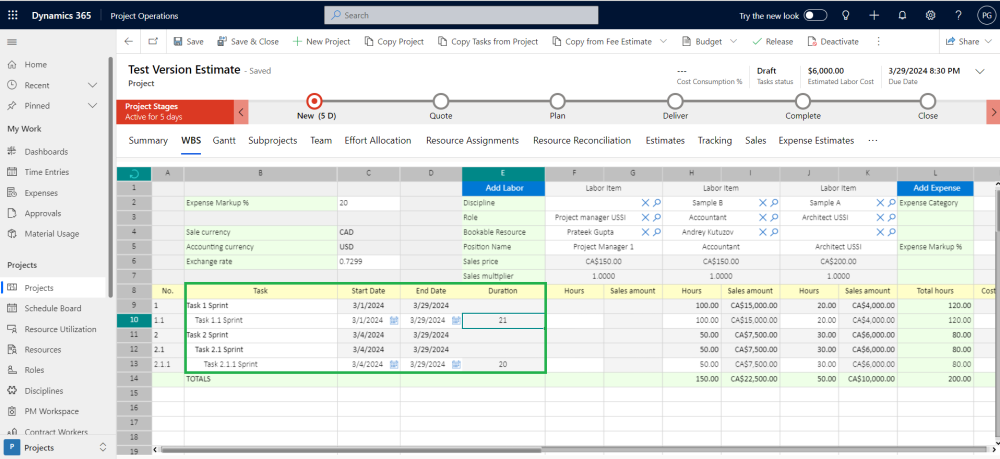

| Start Date | Define the Start Date of Task. |
| End Date | Define the End Date of Task. |
| Duration | It is calculated based on the start and end dates you set. The difference between those dates determines how long the task takes. |
There are two helpful blue buttons in the WBS that make managing roles and expenses easier:

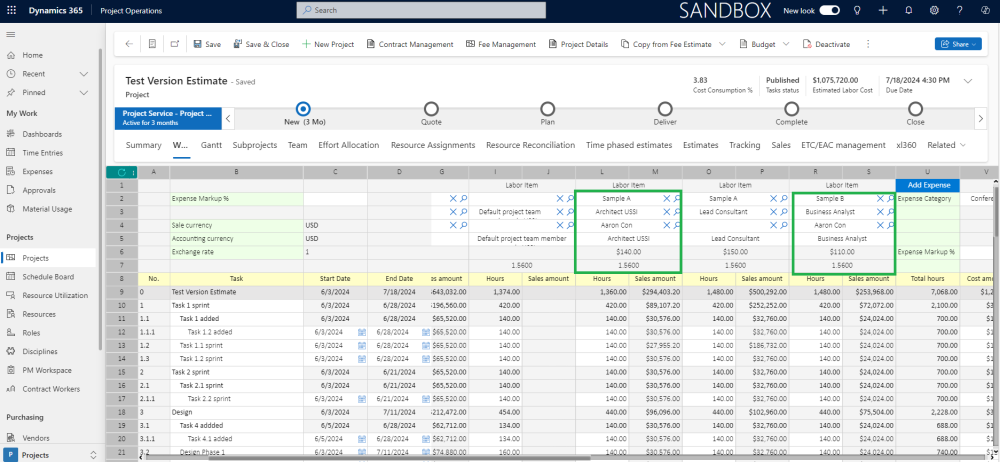

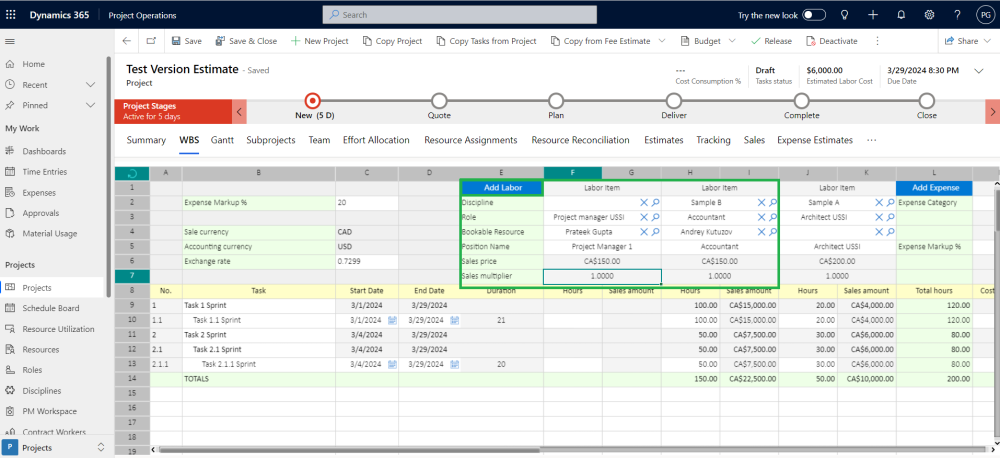

Add Labor button :
Clicking the “Add Labour” button opens a list where you can choose roles for a task. Click it multiple times to add as many roles as needed, making it easier to set budgets for everyone working on it. By default, you’ll see options like “Role,” “Person available,” “Job title,” “Price you charge,” and “Multiplier for adjusting the price.”
The fields which are part of “Labor button” are:
| Fields | Description |
| Discipline | Disciplines can be defaulted for Roles and Bookable Resources. |
| Role |
|
| Bookable Resource | Click the dropdown menu of Bookable Resources and choose the resource you want from the list. Bookable Resource is an optional field and can be left blank and users can only select the role, blank resources will be interpreted as generic resources by the system. |
| Position Name | When users choose a role, its description will default from the selected role. |
| Sales Price | The Sales Price value will be populated from the Sales Price list related to the Opportunity. |
| Sales Multiplier | The Sales Multiplier will be populated from Sales Price List markup and if there is no markup then it is defaulted as “1”. The Sales multiplier will be applied on top of Sales price to calculate the final Sales Amount. |

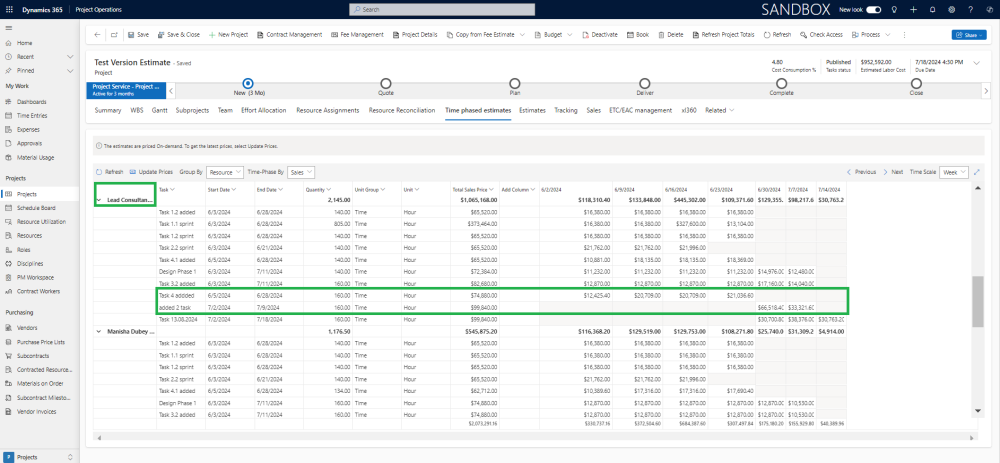

Users also have the flexibility to view different Cost and Sales Estimations for Roles . This helps them get an overview of the forecasting and make necessary adjustments if needed. Once labor items are added and necessary details are either auto-generated or manually added, users will be able to see below fields under different labor items.
| Fields | Description |
| Hours | Users must manually input the total number of hours for the labor they will perform on a particular task. |
| Sales Amount | The Sales Amount of the Labor/Role will be calculated as Sales Price * Sales Multiplier * Hours. |
| Total Hours | Total Hours is the total number of hours estimated for labor across all tasks.
|

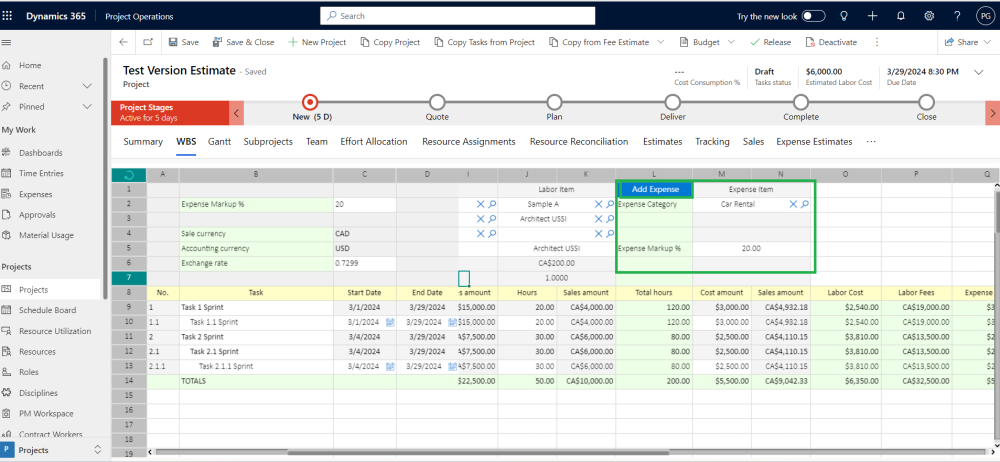

Add Expense Button
Clicking the “Add Expense” button lets you add different costs to a task. Click it multiple times to add as many cost categories as you need, making it easy to track everything. When you do this, you’ll see fields like:
| Fields | Description |
| Expense Category | The “Expense Category” field shows you all the types of expenses that are currently used in your system. |
| Expense Markup % | If you choose a Expense Markup % in WBS, then that percentage will be shown in the “Expense Markup%” field , but you can still change it for each individual expense category you add. |
After adding expenses and filling in the details, you’ll see both the cost and sales amount for each expense. Here is detailed explanation of both the fields:
| Fields | Description |
| Cost Amount | Users need to enter the cost amount for each expense they added under a expense category. |
| Sales Amount | Sales Amount calculation varies with Sales and Accounting currency, can be demonstrated with help of some scenarios:
|
There are even more useful fields in the WBS spreadsheet for managing expenses and roles. Here are the fields description highlighted below.

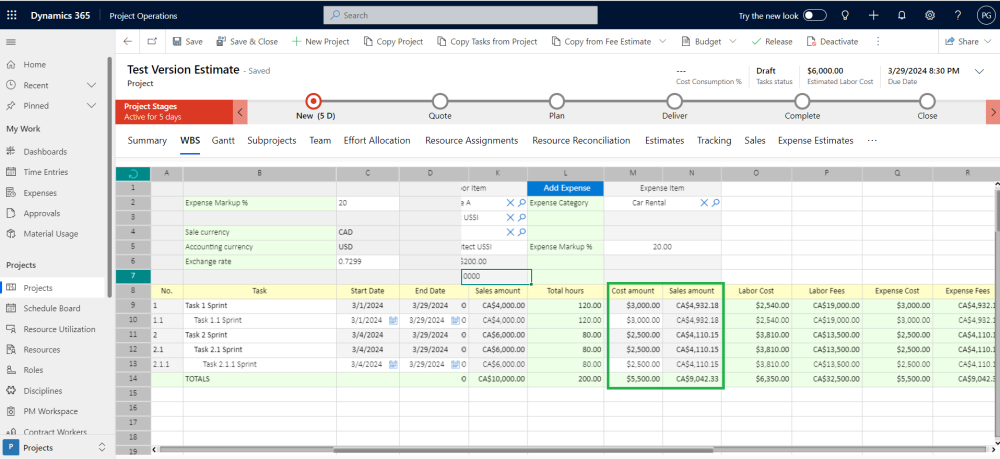

| Fields | Description |
| Labor Cost | “Labor Cost” adds up the costs of all roles/resources assigned to different tasks in “Accounting Currency”. |
| Labor Fees | The “Labor Fees” is sum of all the Sales Amount from all the tasks in “Sales Currency”. |
| Expense Cost | The “Expense Cost” is the total of all the different costs added up for each task in “Accounting Currency” . |
| Expense Fees | “Expense Fees” are the total sum of all Sales Amounts for Expense Items defined at every task level in “Sales Currency”. |
| Total Cost | The “Total Cost” is the sum of the “Labor Cost” and the “Expense Cost” for a task in “Accounting Currency”. |
| Total Fees | The “Total Fees” is the sum of the “Labor Fees” and the “Expense Fees” for a task in “Sales Currency”. |
| Total Fees(ACC CUR) |
|
| Profit | The WBS can be used to track and analyze the actual profit for a project by comparing the actual costs incurred with the originally planned costs and sales price. Profit = Total Fees (ACC CUR) – Total Cost. |
| Margin % | Margin percentage in a Work Breakdown Structure (WBS) is a measure of the profit or markup applied to the cost of work at each level of the breakdown. Margin % = Profit/ Total Fees (ACC CUR). |
Expense Estimates
Additionally, the manual creation of Expense Estimates is synced with the WBS Planner. This sync ensures that any changes made directly to the expense cost or sales amount in either the WBS tab or the Expense Estimates tab will be reflected in the other.
- Users can still see that the sales amounts for expense items in the WBS change based on applicable exchange rates if they adjust the cost in the WBS first. This functionality continues to be supported. Additionally, the sales amount field for an expense item is now editable in the WBS, allowing users to manually input their own values. This enables the syncing of the cost and sales amount of an expense item in Expense Estimates.
- Users can now also add new expense items by selecting tasks and expense categories with cost and sales in Expense Estimates. These items will directly sync to the WBS under the same task name. Additionally, if a user provides multiple lines of expense items for the same tasks and expense categories in Expense Estimates, the system will create corresponding lines of expense items with the same expense category in the WBS.

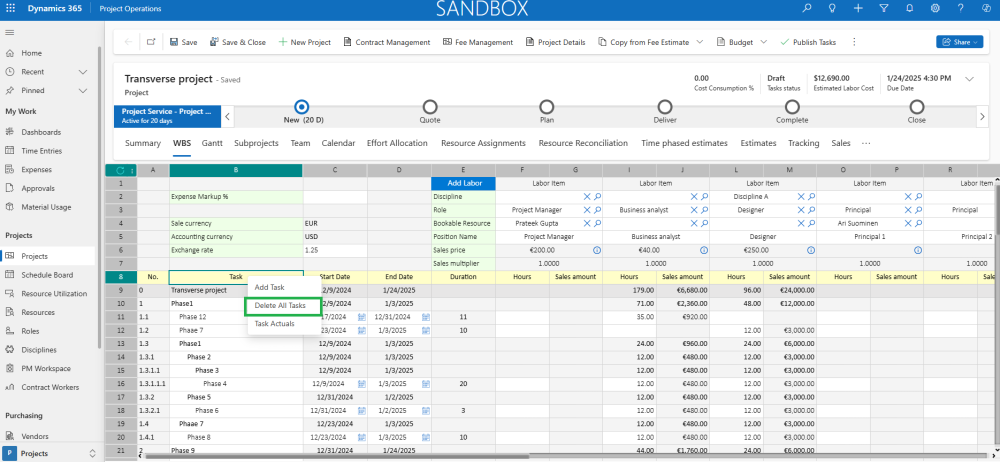

‘Delete All Tasks’ option in xl360 spreadsheets

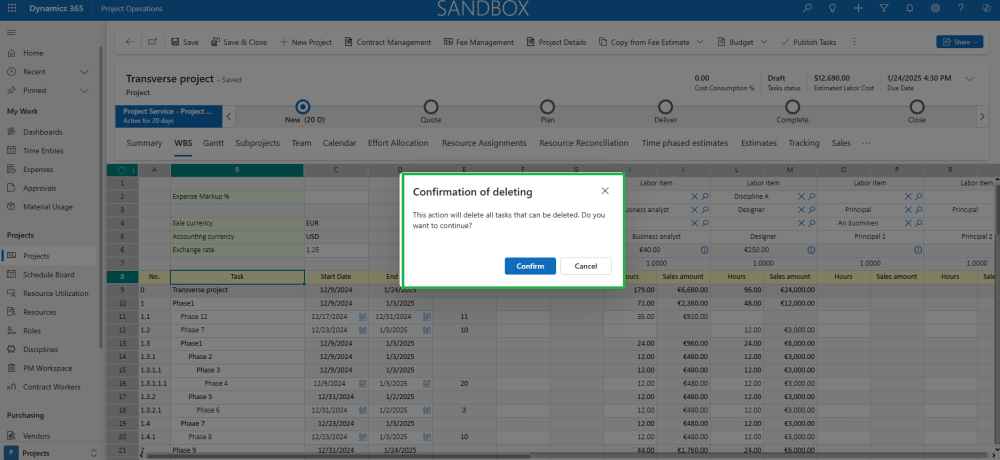

A new contextual menu option, ‘Delete All Tasks’, that enables users to delete all existing tasks from xl360 spreadsheets, including Fee Estimator, WBS Planner, and Effort Allocation.
- When selected, this option prompts users with a confirmation dialog to ensure they want to proceed with deleting all existing tasks.
- The “Delete All Tasks” option will only delete tasks where the previously existing ‘Delete Task’ option is enabled. Tasks or subtasks synced to F&O and related to existing actuals or journals cannot be deleted.

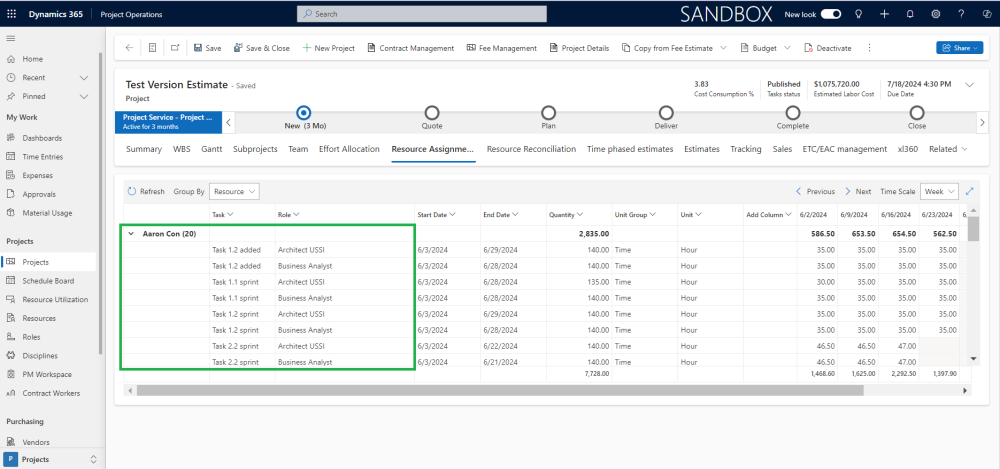

Ability to assign multiple roles for the same bookable resource in WBS
This feature enables users to assign the same Bookable Resource with multiple roles within a task in WBS planner.

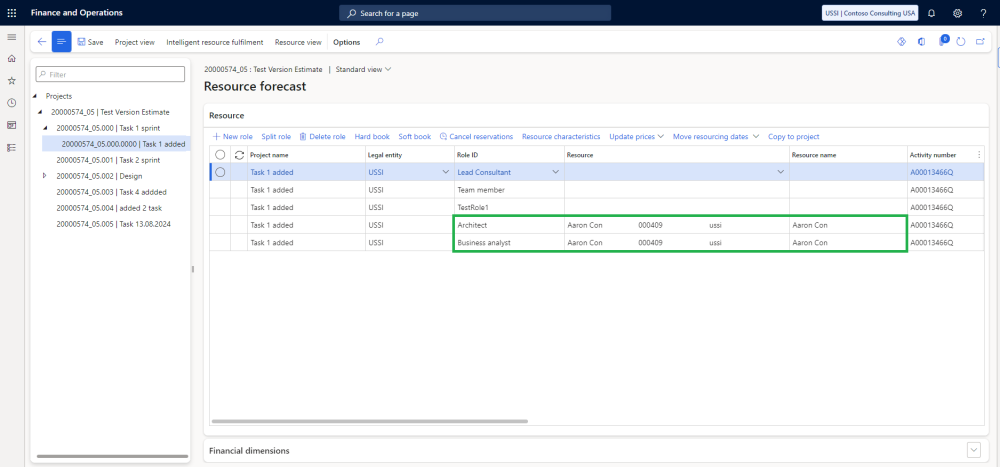

- Same Resource assigned with multiple roles in the WBS are also visible in Team Members, Effort Allocation, Resource Assignment, Resource Reconciliation, Estimates, and Bookable Resource Bookings within Project Operations.
- This facilitates easier cost and sales estimation for the same Bookable Resource with multiple roles in Resource and Hour forecasts in Finance and Operations.
Work breakdown Structure
Resource Assignments
Resource Forecast
WBS calculation of cost and sales amounts of resources based on the varying prices over time
The sales and cost prices of roles/resources in WBS vary dynamically based on values integrated from contract price lists, which defines role prices over different time periods. Depending on the task’s start and end dates, the resource will automatically apply the price effective during that time. This ensures WBS provides accurate cost and sales calculations based on real-time prices, offering better financial insights.
- The WBS updates cost and sales calculations in real-time based on the latest pricing. Users can get the current sales and cost amounts by clicking the “Update Labor Prices” button.
- When price changes are configured within the system (for example, in a Contract price list), the WBS automatically recalculates cost and sales amounts without requiring manual intervention. This reduces errors and ensures that estimates are always up-to-date with the latest pricing data.
- If a resource is assigned to a task that spans multiple time periods with varying cost or sales rates, the WBS ensures precise estimation of both sales and cost prices. It achieves this by matching the “effective from” date of the price list with the task’s start and end dates in the WBS. For each period, the appropriate rates are applied, ensuring that cost and sales amounts are accurately calculated according to the relevant time-based pricing.
Contract price list is set up with different rates for the “Lead Consultant” role at specific time intervals.
The WBS automatically updates sales amounts by matching the “Effective from” date of the price list with the task’s start and end dates. It smartly applies the correct price based on which date range the task falls into. For example, in the attached screenshot for the “Lead Consultant” role, different sales prices are shown because one task’s dates align with one price override, while another task’s dates fall under a different price segment. This ensures accurate and real-time pricing for each task period, reflecting the correct rates.
The Estimate tab gives a clear and detailed view of sales and cost prices by breaking them down into daily, weekly, or monthly intervals. This helps users see financials more clearly and improves accuracy in project forecasting and cost analysis.
